Chapter 10: Quality & Acceptance

Quality Differentiation, Defect Recognition, Quality Control, and Acceptance Standards

10.1 Quality Differentiation: Good vs. Poor Installation

The difference between a compliant lightning protection installation and one that merely appears compliant is often invisible to the untrained eye — until a surge event reveals the weakness. The following side-by-side comparison illustrates the key visual indicators that distinguish a high-quality installation from a poor one. Understanding these differences enables engineers and inspectors to identify deficiencies during site visits and acceptance testing.

Side-by-side quality comparison: Good vs Poor lightning protection installation

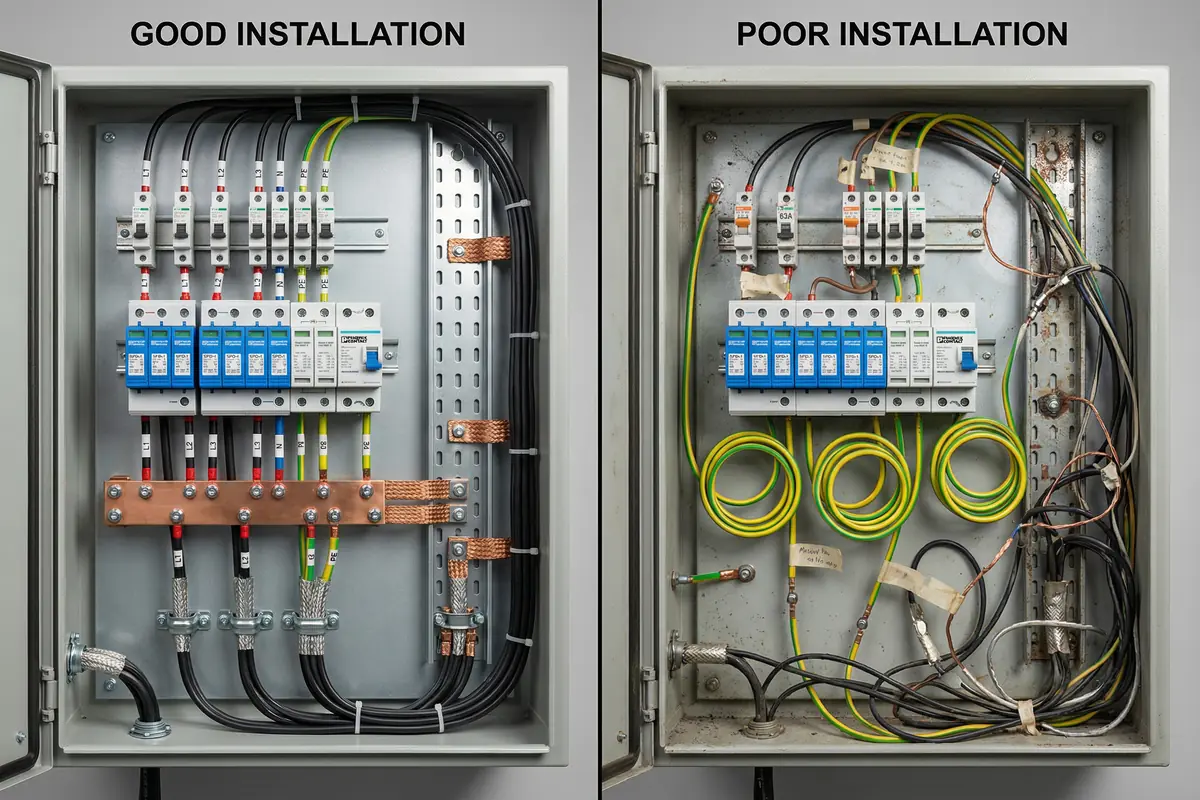

Figure 10.1: Side-by-Side Quality Comparison — Left: Good installation with short straight SPD PE leads, labeled conductors, correct backup MCBs, bonded tray joints, and 360° shield clamps. Right: Poor installation with long coiled earth leads, missing labels, random grounding to painted surfaces, unbonded tray joints, and shield pigtails.

How to Identify Installation Quality On Site

The following checklist provides practical guidance for identifying installation quality during a site visit. Each indicator can be assessed visually or with simple measurement tools, without requiring specialized test equipment. A high-quality installation will pass all ten checks; any failure indicates a deficiency that must be corrected before acceptance.

SPD earth leads are short, straight, and not coiled. Target ≤ 0.5 m; any coiling or looping significantly increases inductance and residual voltage.
Backup protective device ratings match the SPD schedule. Verify fuse/MCB type and rating against the manufacturer's specification for each SPD model installed.
MEB terminals are labeled and accessible. Each terminal should have a unique label identifying the connected conductor; the MEB should be accessible without removing other equipment.
Rack bonding bars are present with dedicated jumpers to major chassis. Each rack should have a bonding bar connected to the MEB, with short jumpers to server and switch chassis.
Tray joints have bonding straps; continuity verified. Every tray joint should have a flexible bonding jumper; verify with low-ohm meter that the tray section is continuous.
Shield terminations use 360° clamps, not long pigtails. Where high-frequency shielding is required, pigtail terminations are inadequate; 360° clamps must be used at defined bonding bars.
All penetrations are registered, sealed, and routed to the entrance facility. No external copper should enter the building without passing through a registered SPD or fiber conversion point.
SPD remote contacts are wired, tested, and mapped to monitoring. Verify that each critical SPD's alarm contact is connected to the NMS and that an alarm test has been performed and documented.
Torque marks on critical bonds indicate controlled tightening. A torque mark (paint or marker line across bolt and terminal) confirms that the connection was tightened to specification with a calibrated tool.
As-built drawings match physical installation. Spot-check five to ten connections against the as-built drawings; discrepancies indicate that the documentation was not updated during installation.

10.2 Defects and Risk Chain Analysis

Each installation defect creates a specific risk chain that can lead to equipment damage, service outage, or safety hazard. Understanding the risk chain for each defect type helps prioritize corrective actions and communicate the urgency of remediation to stakeholders. The following table presents the most common defect types observed in practice, with their risk chains, severity ratings, and corrective actions.

Defect Type Typical Observation Risk Chain Severity Detection Method Corrective Action
Long SPD PE leadsCoiled or looped green/yellow leads; lead length > 0.5 mHigh lead inductance → higher residual voltage at equipment → equipment damage or latent failure during surgeHighVisual inspection; measure lead lengthRelocate SPD closer to MEB; shorten and straighten lead; install local bonding bar if relocation not possible
Missing backup fuse/MCBBlank slot above SPD; wrong rating installed; no protective deviceSPD fails short → fault current not cleared → SPD overheats → fire riskCriticalPanel audit; compare installed device against SPD scheduleInstall correct backup device per manufacturer specification; verify rating and type (gG fuse or C-curve MCB)
Unbonded tray jointsNo bonding straps at tray joints; paint on contact surfacesArcing at joints under surge current → EMI injection → port failures; tray sections at different potentialsHighVisual inspection; continuity mapping by tray sectionAdd flexible bonding jumpers at all joints; remove paint from contact surfaces; verify continuity after installation
Shield pigtail terminationsLong drain wire used instead of 360° clamp; pigtail length > 50 mmPoor high-frequency shield bond → EMI leakage → noise on sensitive circuits; reduced shielding effectivenessMediumVisual inspection; compare against shield policyReplace with 360° clamp terminations at defined bonding bars; update shield policy documentation
Copper bypass patchCopper patch cord crossing zone boundary; unprotected connection bypassing fiber boundaryDirect surge path to core equipment → switch port damage → service outage; security boundary also compromisedHighPatch panel audit; zone boundary verificationRemove copper bypass; restore fiber boundary; lock fiber-only ports; implement change control for patching
Corroded outdoor bondsRusted lugs; green/white oxidation on copper; loose connections at outdoor bonding pointsImpedance rise at corroded connection → reduced bonding effectiveness → repeated small equipment failures; eventual open circuitHighVisual inspection; periodic torque check; continuity measurementReplace corroded lugs; clean contact surfaces; apply anti-oxidation compound; use stainless fasteners; re-terminate
Missing SPD monitoringSPD alarm contacts not wired; no NMS mapping; no alarm test recordSPD fails silently → no alarm generated → system continues operating without protection → next surge causes damageMediumAlarm contact test; NMS mapping verificationWire alarm contacts to NMS DI module; test alarm function; document mapping; schedule quarterly alarm tests

10.3 Quality Control Best Practices

Quality control in lightning protection installation spans five stages: incoming inspection, installation, commissioning, acceptance, and periodic inspection. Each stage has specific activities that must be completed and documented. The following best practices represent the minimum quality control requirements for a compliant installation.

QC Stage Activity Method Documentation Required
Incoming InspectionVerify SPD authenticity, ratings, and remote contacts; check busbar/bonding material certificatesVisual inspection; compare against approved vendor list and SPD schedule; check test certificatesIncoming inspection record; certificate copies; non-conformance report if applicable
Pre-Install Layout ReviewVerify MEB and SPD locations allow short leads; confirm routing plan for separation; confirm shield policyDrawing review; site walk with installer; measure proposed lead lengthsLayout review sign-off; annotated drawings with proposed lead lengths
InstallationEnforce routing rules; use calibrated torque tools; record torque values; apply anti-oxidation compoundSupervised installation; torque wrench with calibration certificate; torque marks appliedInstallation checklist; torque records; photo evidence of key connections
CommissioningContinuity mapping; SPD indicator check; alarm integration test; thermal scan under loadLow-ohm meter (4-wire); visual SPD check; NMS alarm simulation; thermal cameraContinuity test report; SPD check record; alarm test log; thermal scan images
AcceptanceFull acceptance test per acceptance standard table; verify all items pass; sign offPer acceptance test plan; independent verification where requiredAcceptance test report; as-built drawings; O&M manual handover
Periodic InspectionQuarterly visual; annual comprehensive; post-event focused inspectionVisual inspection checklist; low-ohm spot checks; earth measurement; alarm testInspection records; trend data; corrective action register

Key Best Practices (≥10)

1
Incoming inspection: Verify SPD authenticity, ratings, and remote contacts against the approved vendor list and SPD schedule before installation begins.
2
Material certification: Verify busbar and bonding material certificates for corrosion resistance; reject non-compliant materials before installation.
3
Pre-install layout review: Ensure MEB and SPDs can be close-coupled before installation begins; changing locations after installation is costly.
4
Routing rules enforcement: Enforce separation between power and data cables; avoid parallel runs near down conductors; minimize loop areas.
5
Calibrated torque tools: Use calibrated torque wrench for all bonding connections; record torque values; apply torque marks to confirm controlled tightening.
6
Continuity mapping: Perform comprehensive continuity mapping from racks, trays, and shield bars to MEB; document results as baseline for future comparison.
7
UPS bypass verification: Verify UPS bypass and generator/ATS paths are included in the SPD schedule; do not accept a system where bypass is unprotected.
8
Alarm integration test: Simulate SPD failure contact (open/close) and confirm NMS receives, classifies, and records the alarm before acceptance sign-off.
9
Penetration register: Document and label all entry points; verify that no external copper enters without passing through a registered SPD or fiber conversion point.
10
Post-install thermal scan: Perform thermal camera inspection under load for all panels and major bonding connections; identify hot spots before handover.
11
Storm event checklist: Create a post-storm inspection checklist and conduct a tabletop drill before the first storm season after installation.

10.4 Acceptance Standards and Test Items

The acceptance test plan defines the specific tests, methods, pass criteria, and evidence requirements for each category of acceptance testing. All items must be completed and documented before the system is accepted. Pass criteria are project-defined examples; actual criteria must be agreed with the project specification and local code requirements.

Category Test Item Method Pass Criteria (Example) Evidence Required
FunctionalSPD installed per schedule (type, location, model)Physical inspection against SPD scheduleCorrect model and location for every SPD in scheduleAnnotated photos; signed checklist
ElectricalBonding continuity (racks, trays, shields to MEB)4-wire low-ohm meterStable low-ohm continuity at all test points (project-defined threshold)Test report with point-by-point results
ElectricalEarth electrode resistance measurementFall-of-potential method at MEB test linkWithin design target (project-defined, e.g., ≤ 10 Ω)Test report; test point photo; weather conditions recorded
IntegrationSPD alarm contact to NMSSimulate alarm contact; verify NMS receiptAlarm received, classified, and logged within 60 secondsNMS screenshot; alarm log export
PerformanceEthernet throughput (SPD insertion loss)iperf3 or equivalent; compare to baselineMeets specified link rate; no degradation vs. baselineTest log with timestamps
ReliabilityUPS path SPD coverage verificationDrawing review + physical inspectionAll UPS paths (normal, bypass, generator) covered in SPD scheduleAnnotated SLD; inspector sign-off
SecurityZone boundary integrity (no copper bypass)Patch panel audit; port mappingNo copper connections crossing zone boundaries; all inter-zone links are fiberPort map; patch panel photo
InterfacesCoaxial/RS-485 protection functionPhysical inspection + functional communication testNo communication degradation after SPD installation; VSWR/insertion loss within specRF test log or comm test record
SafetyBackup protective device ratingsPanel audit; compare against SPD scheduleCorrect type and rating for every SPD backup devicePanel inspection photos; schedule comparison
DocumentationAs-built drawings and O&M manualDocument review; spot-check against physicalAs-built drawings match physical installation; O&M manual complete and handed overSigned document handover record
