Chapter 11: Installation & Debugging

Pre-Installation Requirements, Installation Procedures, Construction Norms, and Debugging Methods

11.1 Pre-Installation Requirements

A successful lightning protection installation begins well before the first component is mounted. Pre-installation activities ensure that the environment is ready, the team is qualified, the materials are verified, and the risks are understood. The following requirements must be met before installation work begins. Any unresolved item should be escalated and resolved before proceeding.

Environment, Space, Power, and Network Readiness

CategoryRequirementVerification Method
EnvironmentRoom temperature, humidity, and cleanliness within specification; no active water leaks or condensationVisual inspection; environmental sensor check
SpaceMEB location allows short bonding leads to all racks and SPDs; SPD panel locations allow short PE leads to MEB; maintenance access corridors clearLayout review; measure proposed lead lengths
PowerPanel space available for SPDs and backup devices; UPS topology documented including bypass and generator pathsPanel survey; single-line diagram review
NetworkFiber boundaries defined and documented; patch panel locations confirmed; NMS DI module capacity verified for SPD alarm inputsNetwork diagram review; NMS capacity check

People, Tools, and Materials

CategoryRequirement
PeopleQualified electrical engineer responsible for SPD and bonding installation; safety officer for lockout/tagout; network engineer for fiber boundary and NMS integration
ToolsCalibrated torque wrench (with certificate); low-ohm meter (4-wire Kelvin method); thermal camera; cable labeling machine; fall-of-potential earth tester; PPE (safety glasses, insulated gloves, hard hat)
MaterialsAll SPDs verified against approved vendor list and SPD schedule; bonding busbars and conductors with material certificates; anti-oxidation compound; heat-shrink label sleeves; stainless fasteners for outdoor bonds; spare SPD cartridges

Pre-Installation Risk Prechecks (≥12)

1Confirm earthing electrode system exists and test point (earth test link box) location is accessible and labeled.
2Confirm room layout allows MEB placement near entry/distribution point with short lead routes to all racks and SPDs.
3Verify panels have physical space for SPDs and backup devices; confirm DIN-rail capacity and busbar clearance.
4Confirm UPS topology documentation includes bypass path and generator/ATS path; verify both are included in SPD schedule.
5Create penetration register: list all external lines entering the building, their entry points, and their protection status.
6Verify cable tray/ladder rack continuity plan: identify all tray joints, confirm bonding kit availability, and plan bonding strap installation sequence.
7Confirm separation routes for power vs. data cables; verify that routing plans maintain required separation distances throughout.
8Verify shield policy for each cable type and zone: confirm which cables require 360° clamp terminations and at which bonding bars.
9Confirm availability of torque tools with current calibration certificates; confirm low-ohm meter is calibrated and functional.
10Confirm NMS DI module capacity for SPD alarm inputs; verify that alarm mapping plan is documented and approved.
11Confirm spares: SPD cartridges for each type installed, lugs, bonding straps, fasteners, and labeling materials are on site.
12Safety plan confirmed: lockout/tagout procedures documented; PPE available; panel access authorization obtained; emergency contacts listed.

11.2 Installation Requirements

The following installation demonstration photographs illustrate the key requirements for each major installation task. Each photograph is accompanied by a description of the critical installation details that must be present for the installation to be considered compliant. These requirements apply to all installations regardless of scale.

MEB installation demonstration

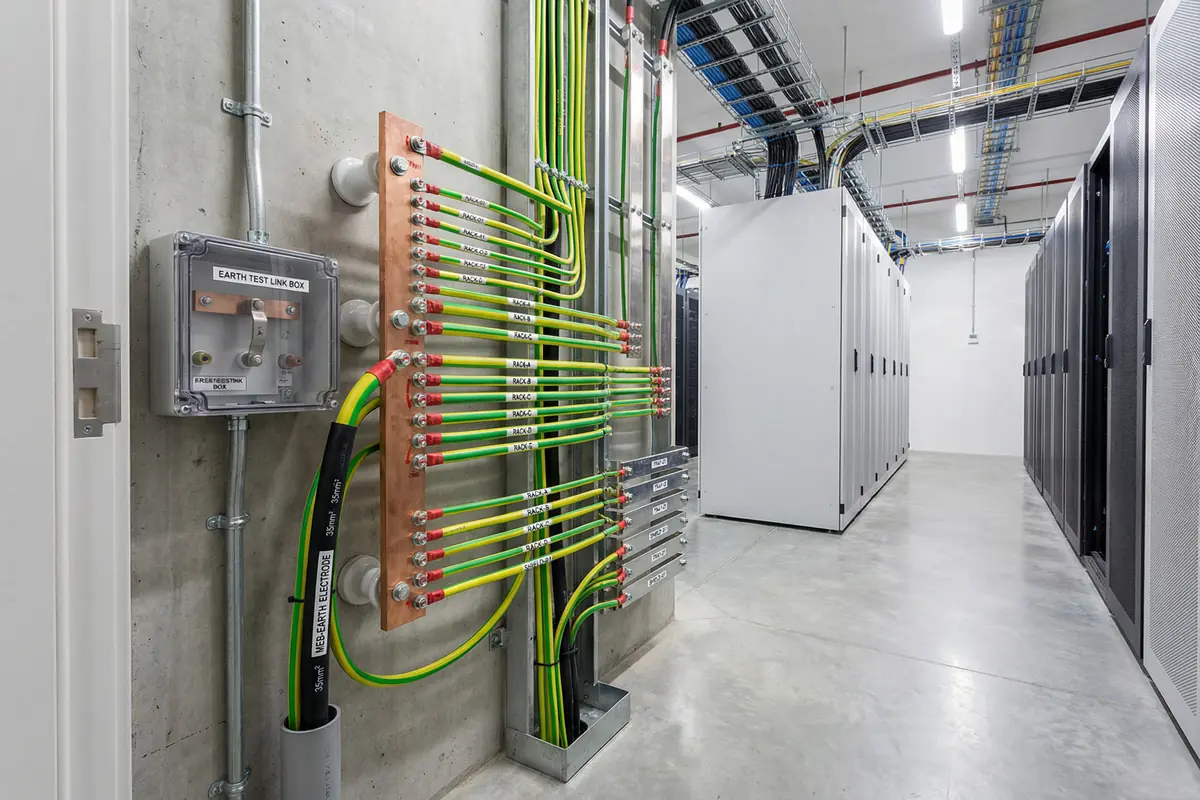

Figure 11.1: MEB Installation — Wall-Mounted Copper Busbar

Wall-mounted copper MEB on insulated standoffs near the room entrance. Labeled terminals with unique IDs on all conductors. Heavy bonding strap to main earthing conductor. Earth test link box with disconnecting link mounted adjacent. Clear service access corridor maintained in front of the MEB.

SPD panel installation demonstration

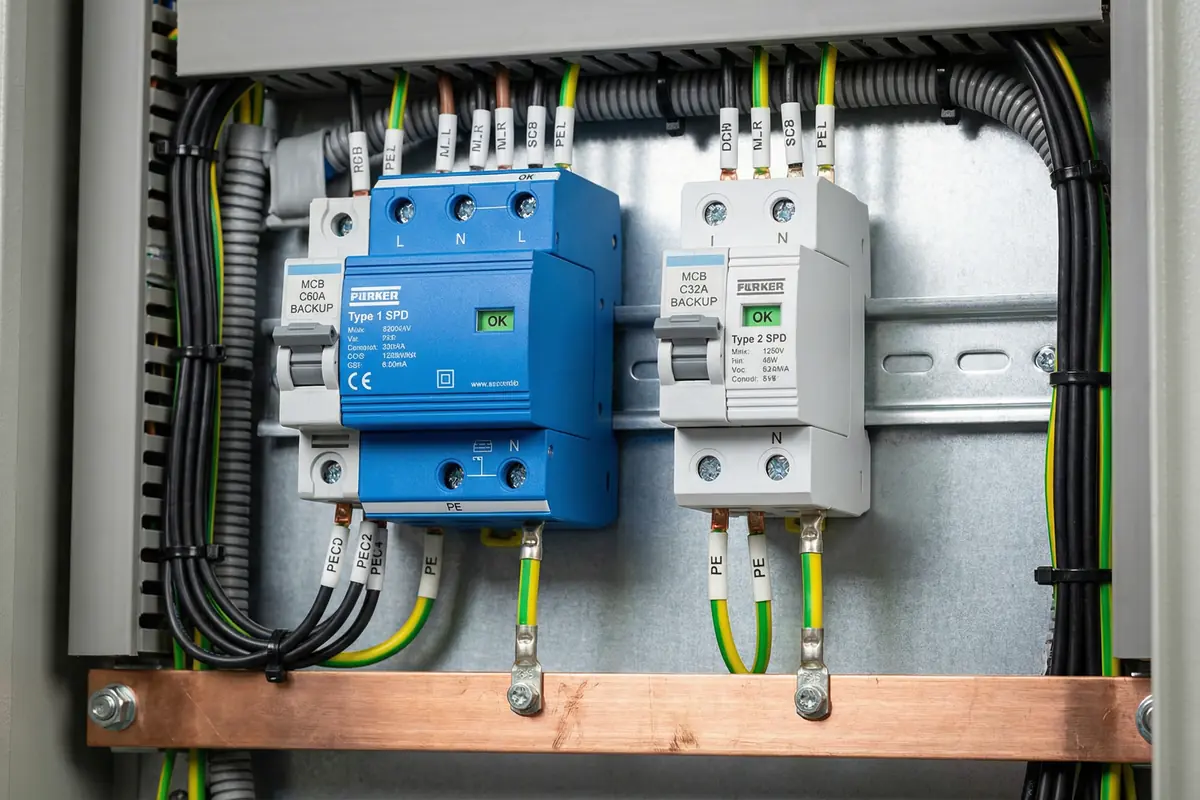

Figure 11.2: SPD Panel Installation — Type 1 and Type 2 in Distribution Panel

Type 1 (blue) and Type 2 (white) SPDs installed on DIN-rail adjacent to busbars. Short straight PE leads (under 0.5 m) connecting directly to copper bonding busbar at panel base. Backup MCBs labeled with ratings. Wiring dressed neatly. SPD status indicator windows showing green (OK) status.

Complete installation requirements overview

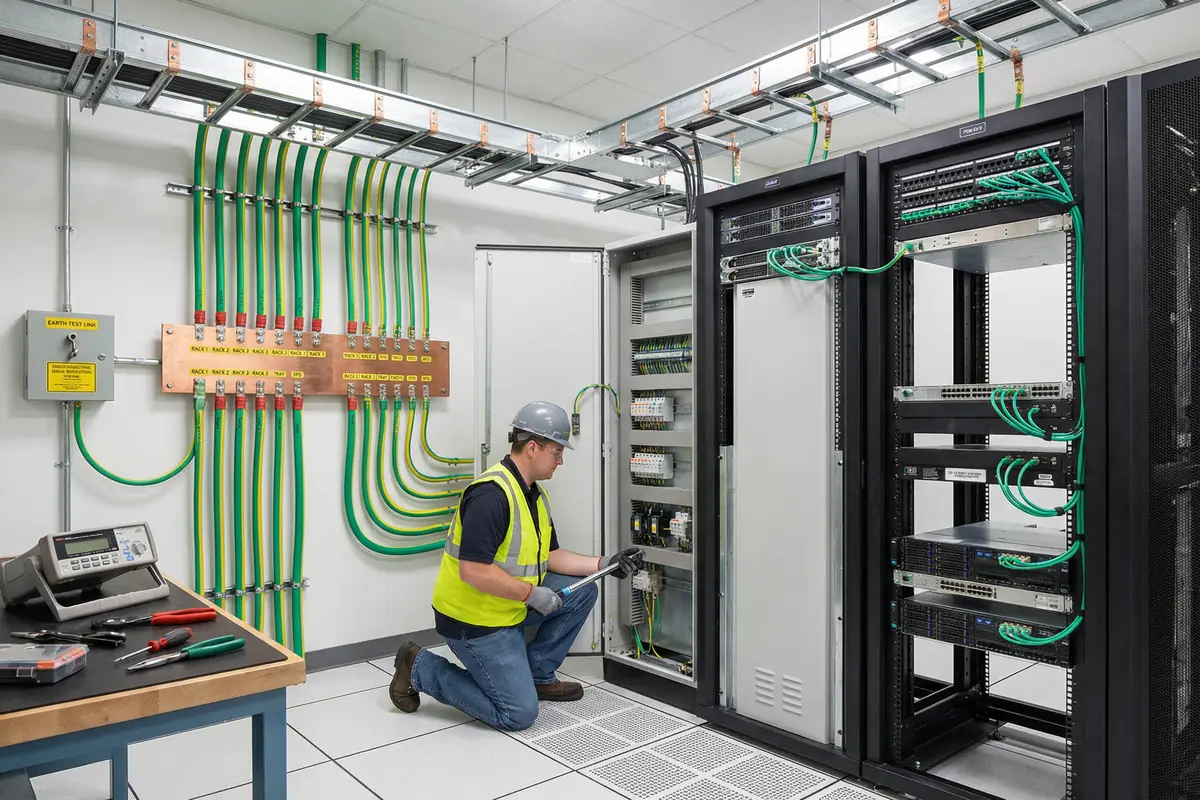

Figure 11.3: Complete Installation Overview — Network Equipment Room

Complete installation showing: copper MEB with labeled terminals and bonding conductors to racks, server racks with rack bonding bars and short jumpers to equipment chassis, overhead cable tray with bonding straps at every joint, SPD panel in electrical cabinet, fiber patch panel at top of rack for inter-zone connections, earth test link box on wall, all conductors labeled.

Correct Installation Steps

1
Install MEB and connect to main earthing conductor with the shortest practical route. Use the specified conductor cross-section; avoid unnecessary bends. Apply anti-oxidation compound at all lug contacts. Torque to specification and apply torque marks.
2
Install tray and ladder rack bonding straps at all joints and at planned intervals (typically every 3–5 m). Remove paint from contact surfaces before installing bonding straps. Use stainless fasteners for outdoor or humid locations. Verify continuity after installation.
3
Install rack bonding bars and bond major chassis (servers, switches, UPS) and rack frames to the MEB via the rack bonding bar. Use short jumpers; avoid routing jumpers through cable management that restricts access.
4
Install power SPDs at defined stages with correct backup devices. Keep PE leads short and straight (target ≤ 0.5 m). Connect PE leads directly to MEB or local bonding bar. Label all SPDs with unique IDs. Wire remote alarm contacts.
5
Install signal SPDs at entry and cabinet points. Prefer fiber conversion across zone boundaries. Where signal SPDs are required, bond to the nearest bonding bar using a short lead; do not ground to rack screws or painted surfaces.
6
Implement shield bonding bars and clamp terminations per the shield policy. Use 360° clamps for high-frequency shielding requirements. Terminate shields at defined bonding bars only; do not create floating shield sections.
7
Wire SPD remote contacts to NMS DI modules. Label all alarm wiring. Perform alarm simulation test and record results. Map each SPD alarm to the NMS with a unique identifier.
8
Create as-built documentation and photo evidence. Update drawings to reflect actual installation. Photograph all key connections including MEB terminals, SPD PE leads, tray bonding straps, and shield terminations. File records for acceptance and O&M reference.

Common Installation Errors and Consequences (≥8)

ErrorConsequencePrevention
MEB placed far from entryLong SPD leads → higher residual voltage at equipment → reduced protection effectivenessPlan MEB location before construction; verify lead lengths in layout review
SPD installed without backup deviceSPD fails short → fault current not cleared → overheating → fire riskEnforce backup device requirement in installation checklist; verify before energization
Signal SPD grounded to rack screwPoor reference and potential ground loops → EMI issues → communication errorsRequire all signal SPDs to bond to designated bonding bar; prohibit rack screw grounding
Tray joints unbondedArcing at joints under surge current → EMI injection → port failures; tray sections at different potentialsInclude tray bonding in installation checklist; verify continuity before acceptance
Shield pigtails used everywherePoor high-frequency shielding → EMC issues → noise on sensitive circuitsEnforce 360° clamp policy; include shield termination in installation training
Copper bypass patch added laterDirect surge path to core equipment → switch port damage → service outagePhysical locks on fiber-only ports; change control for patching; periodic patch audit
Outdoor bonds not corrosion-protectedCorrosion → impedance rise → reduced bonding effectiveness → repeated equipment failuresRequire anti-oxidation compound and stainless fasteners for all outdoor bonds; include in inspection schedule
UPS bypass path omitted from SPD scheduleSurge bypasses UPS protection via unprotected bypass path → equipment damage during UPS maintenance or transferInclude bypass path in SPD schedule; verify in acceptance test

11.3 Construction Norms

Construction norms define the workmanship standards that must be maintained throughout the installation. These norms cover routing, fixing, labeling, grounding, spacing, heat management, and physical protection. Compliance with these norms is verified during installation inspection and at acceptance testing.

CategoryNormCheckpoint
RoutingStrong/weak separation maintained; power and data cables cross at right angles where unavoidable; no parallel runs of power and sensitive data cables within separation distance; avoid routing near down conductorsVisual inspection; measure separation distances at critical points
FixingStrain relief on all conductors at entry points; no sharp bends on bonding conductors; bonding straps protected from mechanical damage; cable ties not over-tightened on bonding conductorsVisual inspection; check for kinks or sharp bends
LabelingUnique IDs for all SPDs, bonding conductors, test points, and penetrations; heat-shrink labels used; labels legible and durable; as-built drawings updated to match labelsSpot-check labels against as-built drawings
GroundingPaint removed at all bonding contact surfaces; correct lug type and size for conductor cross-section; torque applied and marked; anti-oxidation compound applied before lug installationVisual inspection; torque mark verification; low-ohm test
SpacingDefined separation maintained between power and data cables; sensitive cables kept away from down conductors; SPD PE leads not routed parallel to incoming supply conductorsMeasure separation at closest points; verify routing plan compliance
HeatPanel ventilation maintained; SPDs not bundled with other heat-generating equipment; no cable bundles obstructing SPD ventilation slots; thermal scan performed after energizationVisual inspection; thermal camera scan under load
ProtectionAll penetrations sealed with fire-rated compound after cable installation; outdoor entries use IP-rated glands; outdoor bonding connections protected from moisture ingressVisual inspection; verify gland IP ratings; check penetration sealing

Construction Checkpoints

Before Energization
  • Continuity mapping: verify all racks, trays, and shield bars to MEB
  • Visual lead length check: verify all SPD PE leads are short and straight
  • Backup device verification: confirm correct type and rating for every SPD
  • Penetration register: confirm all entries are registered and protected
  • Zone boundary check: confirm no copper connections cross zone boundaries
After Energization
  • SPD indicator check: verify all SPD status windows show OK (green)
  • Alarm integration test: simulate each SPD alarm contact and verify NMS receipt
  • Thermal scan: inspect all panels and major bonding connections under load
  • Functional test: verify network throughput and PoE delivery meet specification
  • Earth measurement: measure earth electrode resistance at test link box

11.4 Debugging Methods

Debugging a lightning protection and network system requires a systematic approach that begins with baseline documentation and proceeds through zone verification, SPD validation, bonding validation, and functional testing. The following process and issue-solving ideas provide a structured framework for identifying and resolving installation issues.

Debugging Process

1
Baseline logs: Record UPS events, switch error counters, and SPD statuses before any changes. This baseline is essential for comparing before and after states when troubleshooting.
2
Verify zoning: Confirm that fiber boundaries are active and that no copper bypass exists. Audit patch panels for unauthorized copper connections crossing zone boundaries.
3
Validate SPDs: Check all SPD indicator windows and remote contact states. Verify that NMS is receiving correct status for all SPDs in the schedule.
4
Validate bonding: Perform spot-check continuity measurements at racks, trays, and shield bars. Compare against baseline; investigate any significant increase in resistance.
5
Run functional tests: Verify network throughput, PoE delivery, and RS-485 communications. Document results and compare against specification.

Issue-Solving Ideas (≥5)

SymptomInvestigation StepsResolution
Frequent port CRC errorsInspect shield termination quality; check routing separation from power conductors; verify no parallel runs near down conductorsImprove shield terminations to 360° clamps; reroute cables to maintain separation; add bonding straps to tray sections near problem ports
PoE drops intermittentlyConfirm PoE SPD compatibility with PoE class; check power budget; verify bonding reference for signal SPDReplace incompatible PoE SPD; adjust power budget; bond signal SPD to designated bonding bar instead of rack screw
SPD alarms nuisance trippingVerify SPD coordination (Up values in cascade); check backup device ratings; verify earthing reference qualityReview SPD cascade coordination; replace incorrectly rated backup devices; improve earthing reference if resistance is high
UPS shows unexplained transfersCorrelate UPS transfer timestamps with storm events; verify bypass path protection; check bonding of UPS chassisAdd or repair SPDs on bypass path; improve bonding; add storm correlation dashboard to NMS
Outdoor device failures repeatInspect corrosion at outdoor bonding points; verify fiber conversion is in place; check gland sealingEnforce fiber conversion for all outdoor links; replace corroded bonds; seal glands; improve corrosion protection

Rollback Policy

Any change that introduces a copper bypass across a zone boundary must be rolled back immediately, regardless of the reason for the change. Troubleshooting activities that require temporary copper connections must be documented, time-limited, and removed as soon as the troubleshooting is complete. Keep spare pre-configured switches and media converters available for rapid swap during fault isolation, so that fiber boundaries can be maintained even during equipment replacement activities.


11.5 Rack, Stack, and Cabling Requirements

Rack layout and cabling practices directly affect both the maintainability and the reliability of the lightning protection system. A well-organized rack makes SPD lead routing straightforward, bonding bar access easy, and fiber boundary maintenance practical. The following requirements apply to all rack installations in the system.

Rack Layout — Top to Bottom Order
1U — Fiber Patch Panel (inter-zone links only)
2U — Copper Patch Panel (intra-zone only; labeled "INTERNAL ONLY")
2U — Core/Distribution Switch
2U — Server / Compute
2U — Server / Compute
2U — Rack PDU (SPD-protected feed)
Side Rail — Rack Bonding Bar with short jumpers to chassis
Maintenance access corridor: 1 m minimum in front of rack Do NOT route cables near power SPD leads Service loops: 300 mm minimum on all patch cords

Cabling Best Practices for Maintainability and Reliability

AspectRequirementRationale
Service loopsMinimum 300 mm service loop on all patch cords; do not use exact-length cordsAllows equipment to be pulled forward for maintenance without disconnecting cables; prevents cable strain
Tight bundling near SPDsDo not bundle cables tightly around or near SPD PE leadsTight bundling traps heat around SPDs; also increases inductive coupling between SPD leads and signal cables
Fiber boundary labelingLabel fiber patch panel ports "ZONE BOUNDARY — FIBER ONLY"; use physical port locks on unused portsPrevents accidental or unauthorized copper bypass; makes boundary visible to all personnel
Bonding bar accessRack bonding bar must be accessible without removing other equipment; route jumpers to allow individual removalEnables periodic torque checks and continuity measurements without service disruption
Cable tray bondingVerify tray bonding strap is not obstructed by cable bundles; maintain access for inspectionAllows periodic torque verification and visual inspection of bonding straps
